- Open a project. Select the Power Grid view from the main navigation.

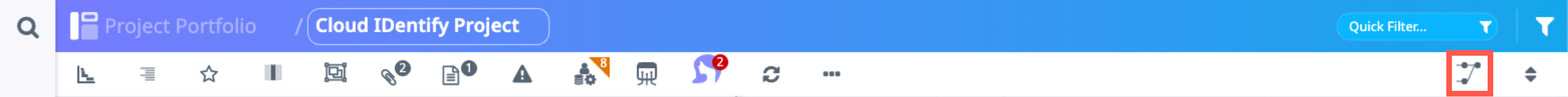

- Click on the Dependencies icon in the upper right corner of the application.

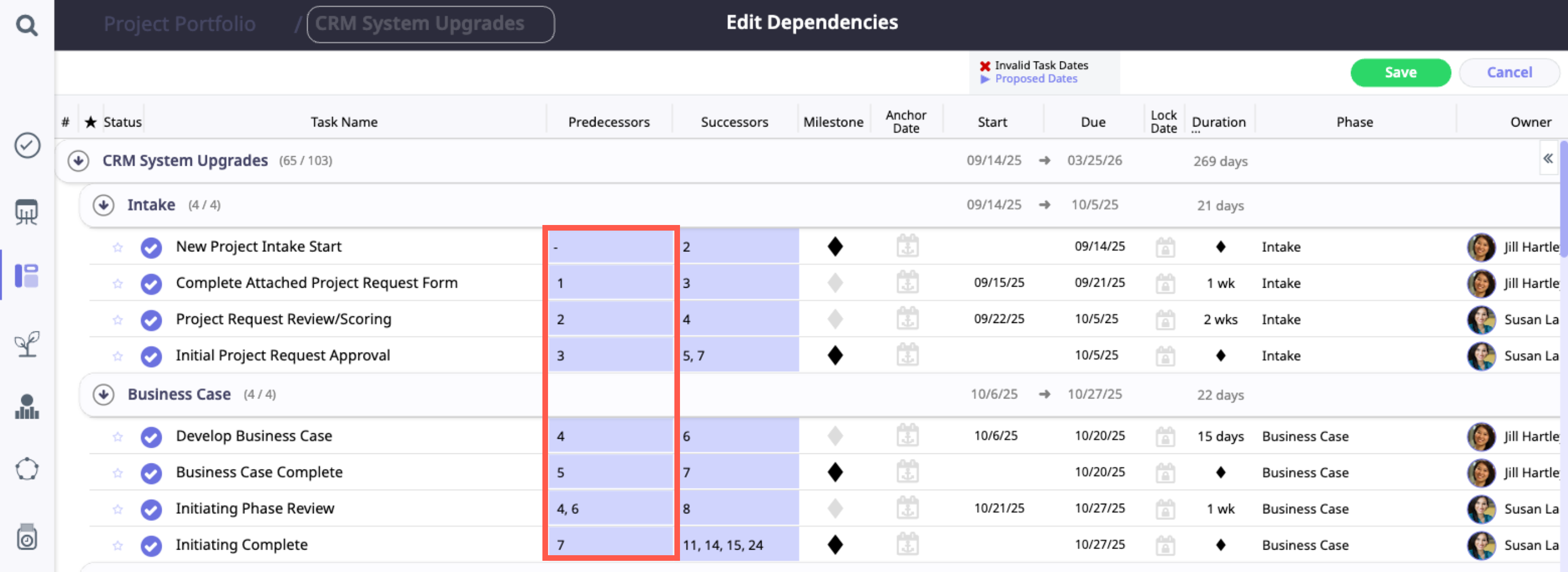

- The Edit Dependencies screen appears. Click into the Predecessors column for the desired SmartTask, and edit.
Multiple tasks may be entered as predecessors or successors by adding a comma between line numbers.
The following dependency types are available by entering the short code alongside the task's line number.- Start-to-Start: SS (e.g. a start-to-start dependency on a task in row 87 would be entered as 87SS)
- Finish-to-Finish: FF (e.g. a finish-to-finish dependency on a task in row 87 would be entered as 87FF)
- Lag: +x"unit of time" where time units are abbreviated as "y" "m" "w" "d" (e.g. a lag of 3 days on a task in row 87 would be entered as 87+3d)
- Lead: -x"unit of time" where time units are abbreviated as "y" "m" "w" "d" (e.g. a lead of 3 months on a task in row 87 would be entered as 87-3m)

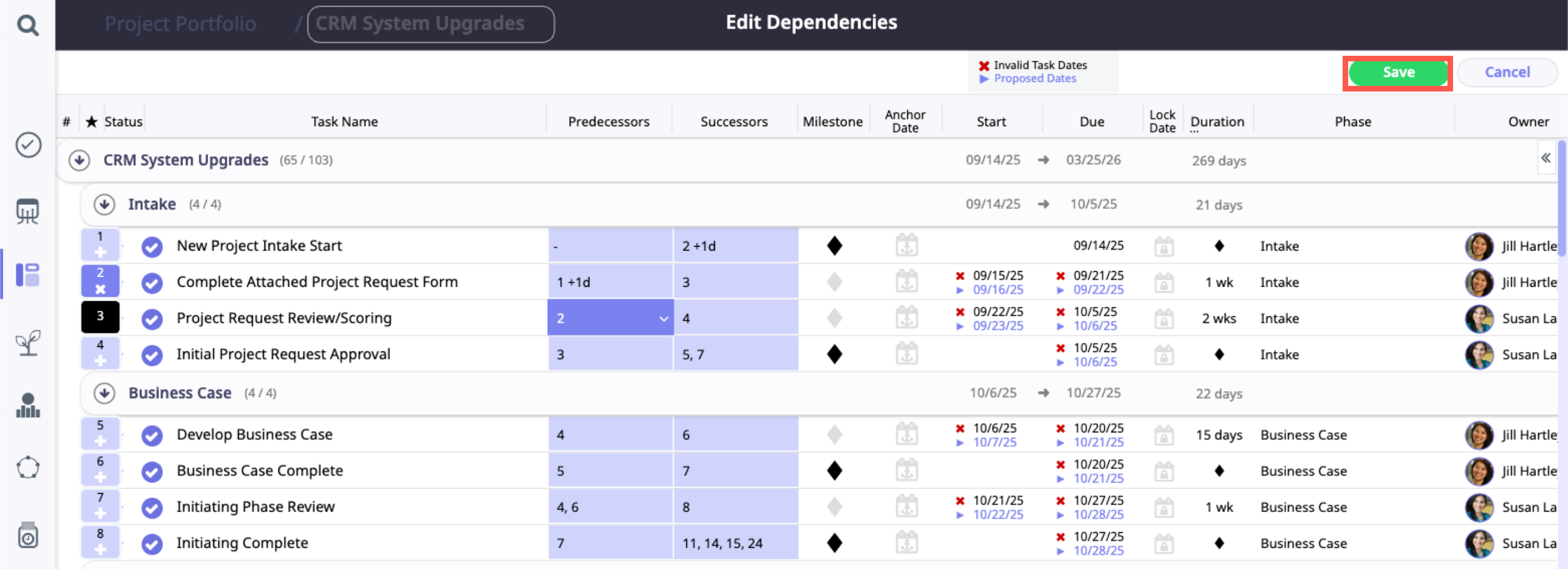

- Upon returning to the Edit Dependencies screen, you may click Save to save all changes made, or Cancel to discard changes.

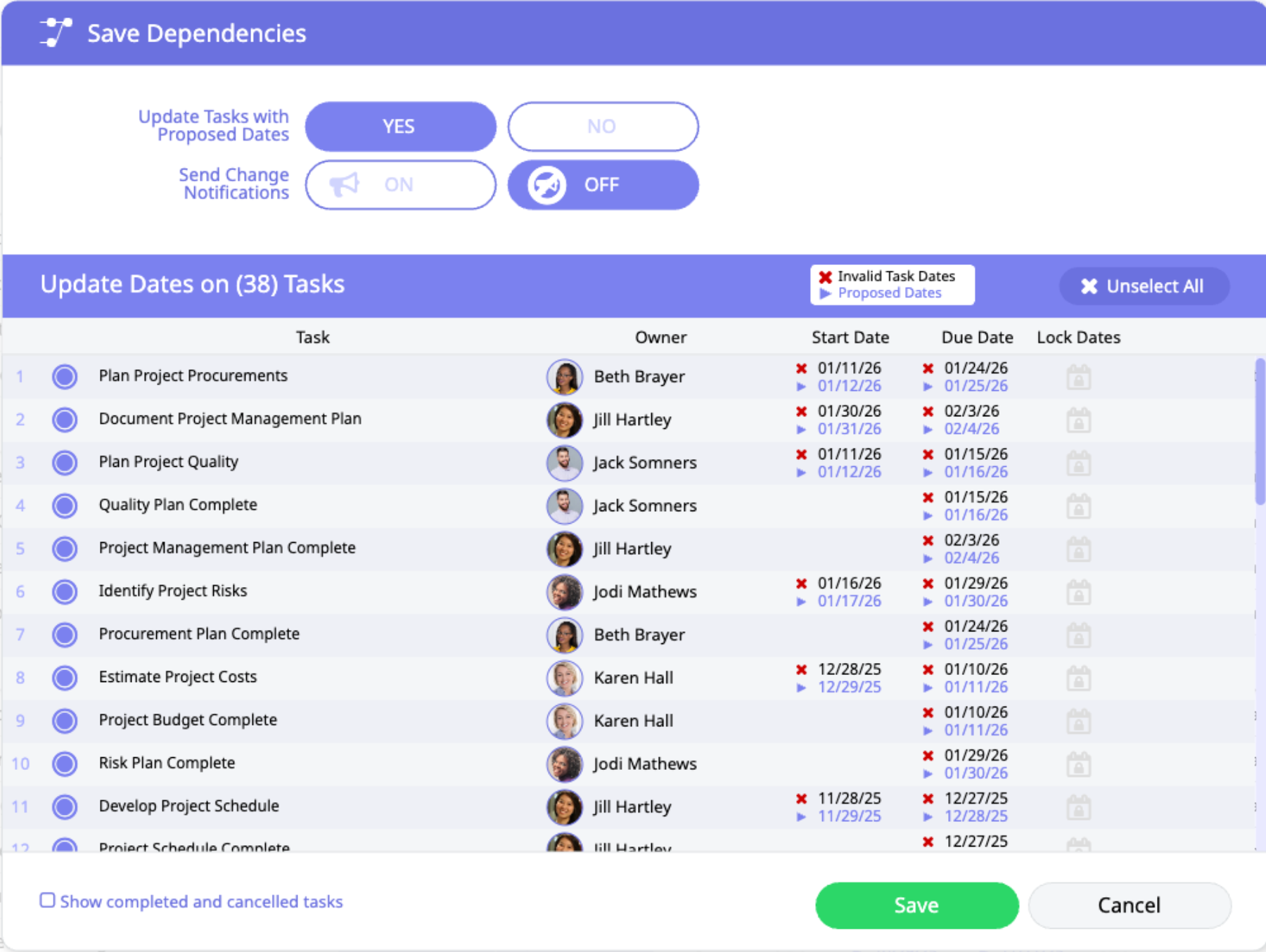

- If changes have been made to dependencies, you will be prompted to update dates on SmartTasks impacted by the changes.
a. Click YES to update SmartTasks with the proposed dates or NO to leave dates as they were previously. b. Click ON, to send out a date change notification, if desired. - Click Save.
